OpenSat Mission Lab v1.7

Constellation Safety and Autonomous Replanning

OpenSat India Flood Watch Constellation

Screened events
6
High/critical
2
Maneuver recommendations
2
Replanned tasks
29

Conjunction assessment

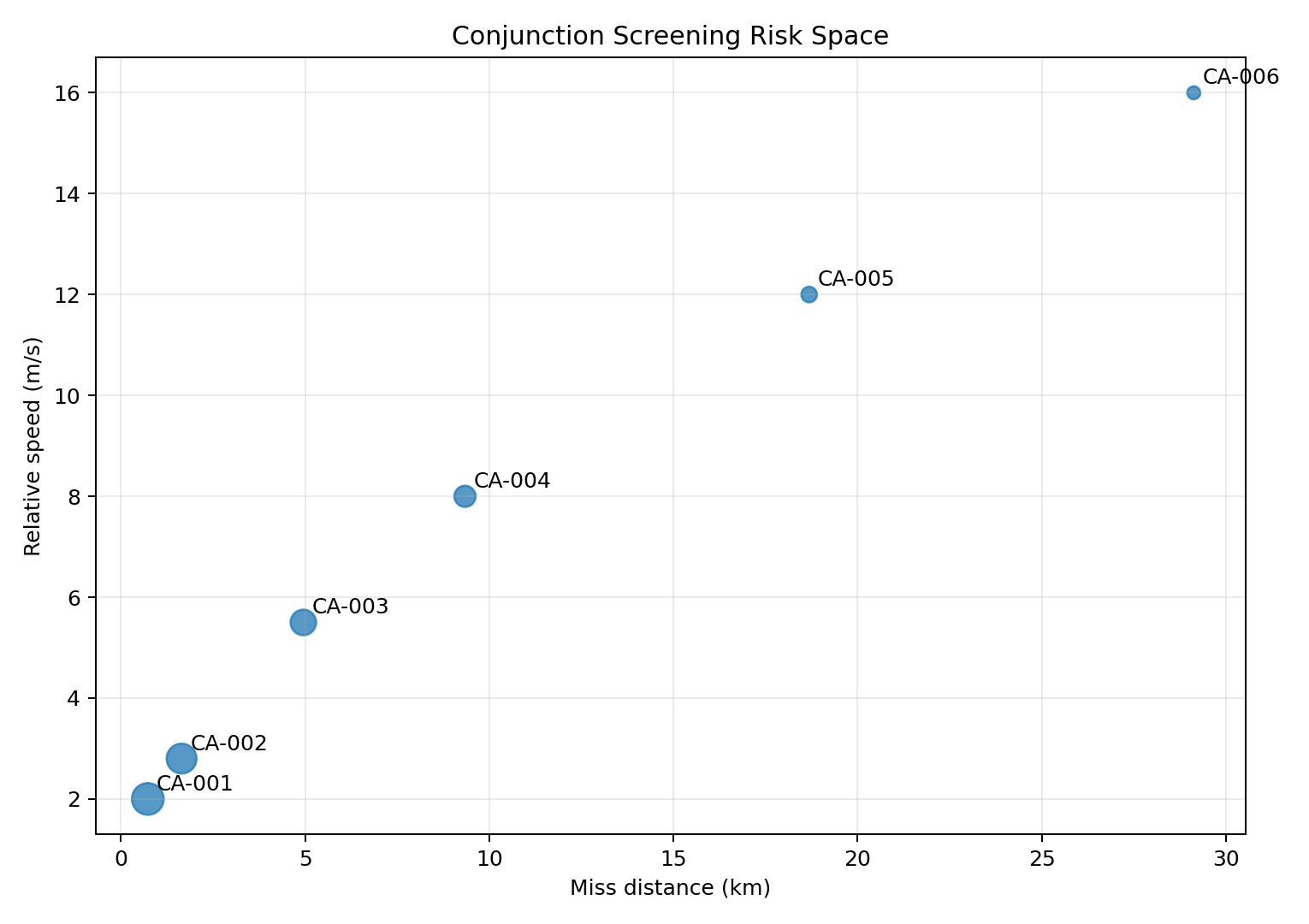

risk matrix
EventProtectedSecondaryMiss kmRelative m/sRisk
CA-001OSML-01SYN-DEBRIS-0010.7332.00critical
CA-002OSML-03SYN-DEBRIS-0021.6502.80high
CA-003OSML-02SYN-DEBRIS-0034.9555.50medium
CA-004OSML-04SYN-DEBRIS-0049.3438.00medium
CA-005OSML-01SYN-DEBRIS-00518.68412.00low
CA-006OSML-04SYN-DEBRIS-00629.12316.00low

Avoidance recommendations

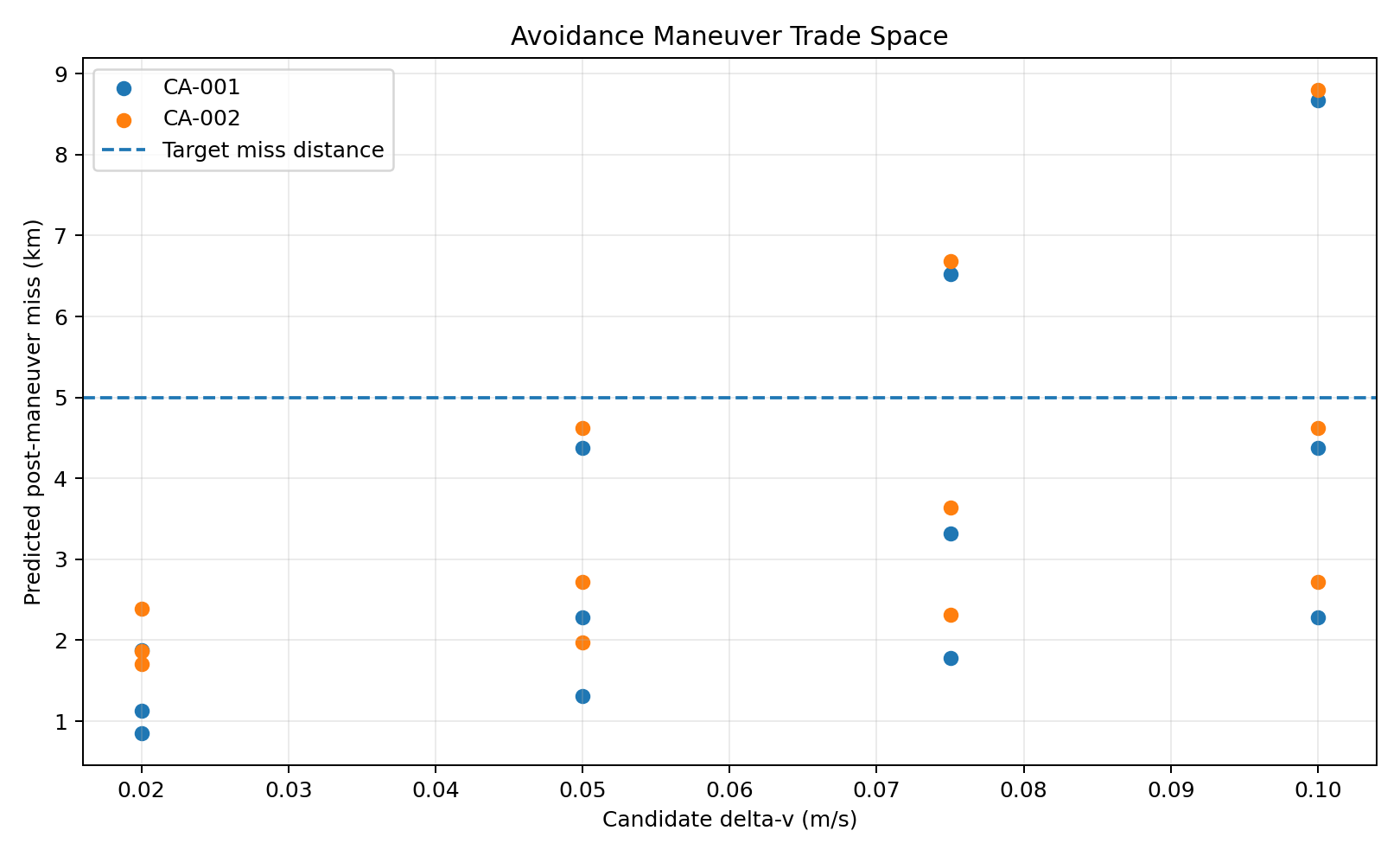

maneuver trade
EventLead hDelta-v m/sPost miss kmPropellant g
CA-001240.1008.670.487
CA-002240.1008.800.487

Autonomous replanned schedule

UTCSatelliteTargetPriorityUtility

Scope: deterministic educational screening and planning. Probability values are proxies, not operational collision probabilities. No maneuver should be executed from this output.
